Budget note card for motel exterior planning before pricing. How to keep motel exterior planning workflow budget notes before pricing
Image: Roadside Edit

Costs

Part of A motel exterior planning workflow, from decision question to next step

How to keep motel exterior planning workflow budget notes before pricing

A motel exterior budget note separates defined work, unknowns, decision points, and change logs so no early number reads as a project quote.

A budget note written before pricing is not a price list. It is a record of four things: what is defined, what is unknown, who decides, and what changed. Keep those four apart and a later estimate stays readable.

What to take away

  • Write four fields per line item: defined item, unknown, decision point, change log.
  • Name the missing record and the person who can resolve it, not a guessed repair method.
  • Compare a submitted estimate against the scope card before you compare it against another number.
  • Move an item to a new gate only when its evidence exists, never when a date passes.
  • Keep the note beside its dated source material so a summary is never mistaken for the original.

The four-field note schema

Field What goes in it What stays out
Defined item Documented area and the deliverable requested A guessed repair method
Unknown The record that is missing and who can resolve it A contingency presented as fact
Decision point The person or body that must decide An implied approval
Change log Date, what changed, and the source that changed it A revised number with no context

A photograph of a wall supports a request to document a visible feature. It does not support a conclusion about the substrate behind the finish. Keep that unknown on the same line as the defined item so a later estimate is not read as a complete scope.

Table comparing what belongs in each of four budget note fields versus what stays out (How to keep motel exterior planning workflow budget notes before pricing)
The four-field schema keeps defined work, unknowns, decisions, and changes from blurring into one number. Image: Roadside Edit

Five gates, and the evidence each one needs

Gate Evidence needed Budget status
Exterior recorded Dated observations and stated limits Documentation work can be scoped
Question defined Named feature, access assumption, responsible reviewer Study or design work can be requested
Option selected for review Stated rationale and exclusions A defined design package may be priced
Work boundary prepared Materials, tasks, and limits stated A provider may submit an estimate
Funding decision made Award or commitment with a named purpose Only that activity can be called supported

An unknown condition stays at its gate. Do not move a generic contingency into the public table and call it a known repair. When a new source changes the boundary, add a dated revision note naming the changed item and leave the older scope in place.

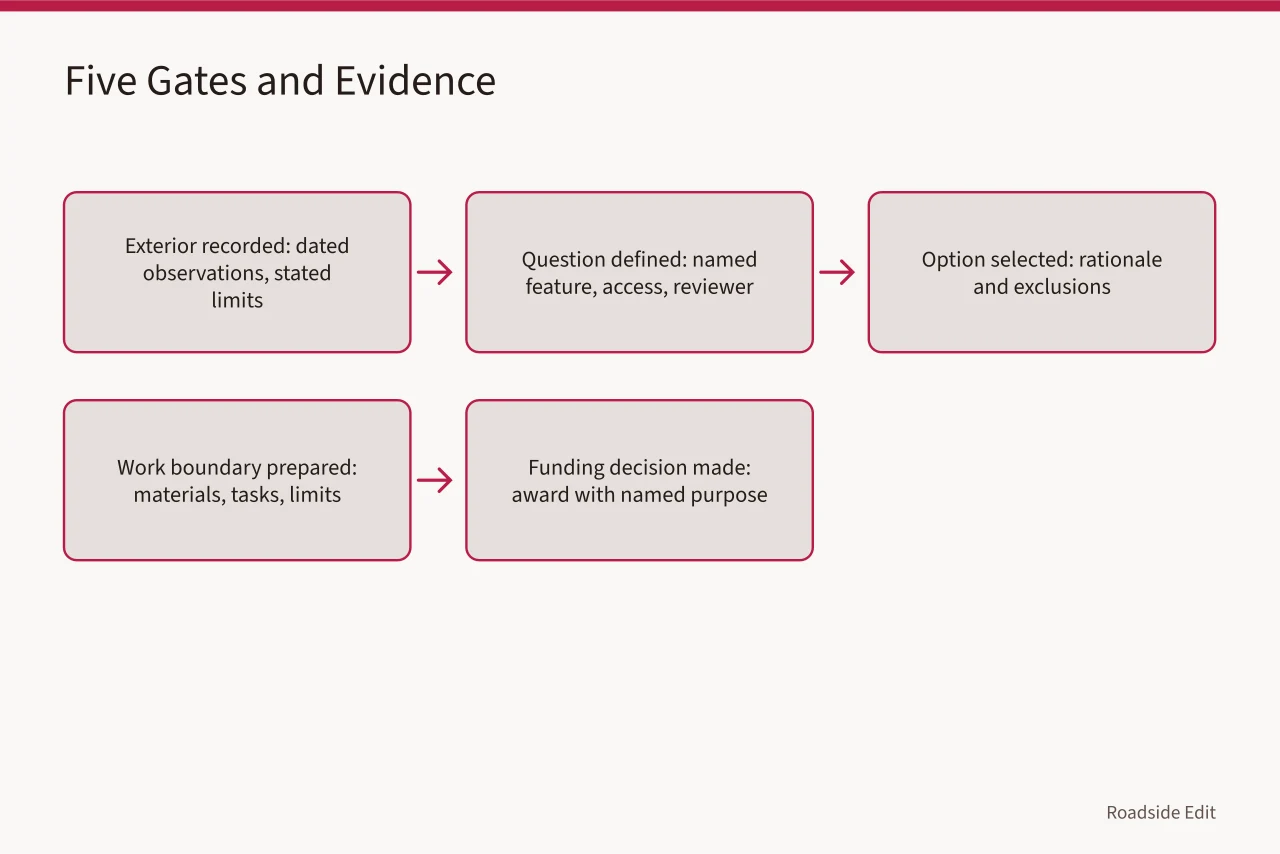

Five sequential gates from exterior recording to funding decision with required evidence (How to keep motel exterior planning workflow budget notes before pricing)
Each gate holds a decision, and an unknown condition stays at its gate until evidence moves it forward. Image: Roadside Edit

Worked example: a 1962 motel, flat canopy and porcelain sign

A survey team documents a two-story 1962 motel: brick veneer, a flat canopy over the office door, and a porcelain-enamel sign on a pole at the curb. The note reads:

  • Defined item: canopy soffit, 40 linear feet, photographed and measured 2026-06-14.
  • Unknown: whether the soffit finish is original or a later repaint. Resolve by finish analysis, requested from the State Historic Preservation Office reviewer.
  • Decision point: whether the sign stays in place or is removed for repair. Owner and local landmarks commission decide.
  • Change log: 2026-06-20, survey area extended to the dry-stand pipe after the field notes showed it inside the canopy footprint.

The canopy line sits at gate two. The sign line sits at gate three, because the removal question is open. Neither line has a submitted estimate, and the note says so rather than leaving a blank that a reader fills with a guess.

A note like this is what the motel exterior planning sequence is built on, because each gate holds a decision rather than a total.

Reading a submitted estimate

When a provider sends information, compare the document to the scope card first. Does it name the area? Does it state exclusions? Does it separate site visit, design, materials, and labor? Does it separate permits and allowances? An unclear answer is a question to record, not a gap to fill.

Label the number by its stage: submitted estimate, planning allowance, or design package. A figure can help sequence internal work. It is not proof of value, quality, compliance, or final cost.

The GAO Cost Estimating and Assessment Guide sets out that an estimate needs several things. These are:

  • a stated purpose
  • scope
  • assumptions
  • data
  • methods
  • updates It governs federal estimating rather than a motel exterior, and its structure is the reason to keep each figure tied to the stage that produced it.

Keeping the record

Store the note beside its dated source material. When a scope item changes, revise the note with the date and the reason.

When access, authority, or a technical condition is still unknown, write that plainly. The National Archives records-management resources describe inventory, scheduling, appraisal, and oversight in the federal context.

They do not set private record rules, and they show why a later reader needs to tell an original proposal from a summary.

If a sponsor, designer, or provider supplied a price, keep that submission separate from your own research and state the relationship near any recommendation. The FTC's endorsement guidance says material connections should be disclosed when they could affect how readers weigh an endorsement. A disclosed price is still that source's statement, not an independent market finding.

The NPS guidance on additions asks a proposal to describe its scope, rationale, and design, and treats written description with photographs of existing conditions as baseline documentation. Watch the NPS scope-and-documentation discussion.

It is not a motel estimating manual, and it is the reason to understand the property and the proposed change before treating an early number as a project cost.

Common questions

Is an early estimate a project budget?

Not by itself. Read it with its date, scope, assumptions, exclusions, and open questions. Then place it at the gate that matches its evidence.

Should an article publish exact project costs?

Only when source, date, location, scope, and context can all be stated. A general guide should not manufacture a quote.

What belongs in an allowance note?

The item, its evidence basis, the assumption behind it, the decision owner, and the condition that would change it.
